A tidy forecasting workflow
![]()
Foundations
Forecasting requires methodological discipline:
- Split the data (train/test)
- Establish benchmark models
- Forecast
- Measure accuracy
- Select a baseline
- Refit and produce the final forecast
Example dataset
We use a built-in dataset from fpp3: aus_production.
- It is already a
tsibble
- It contains multiple economic production series

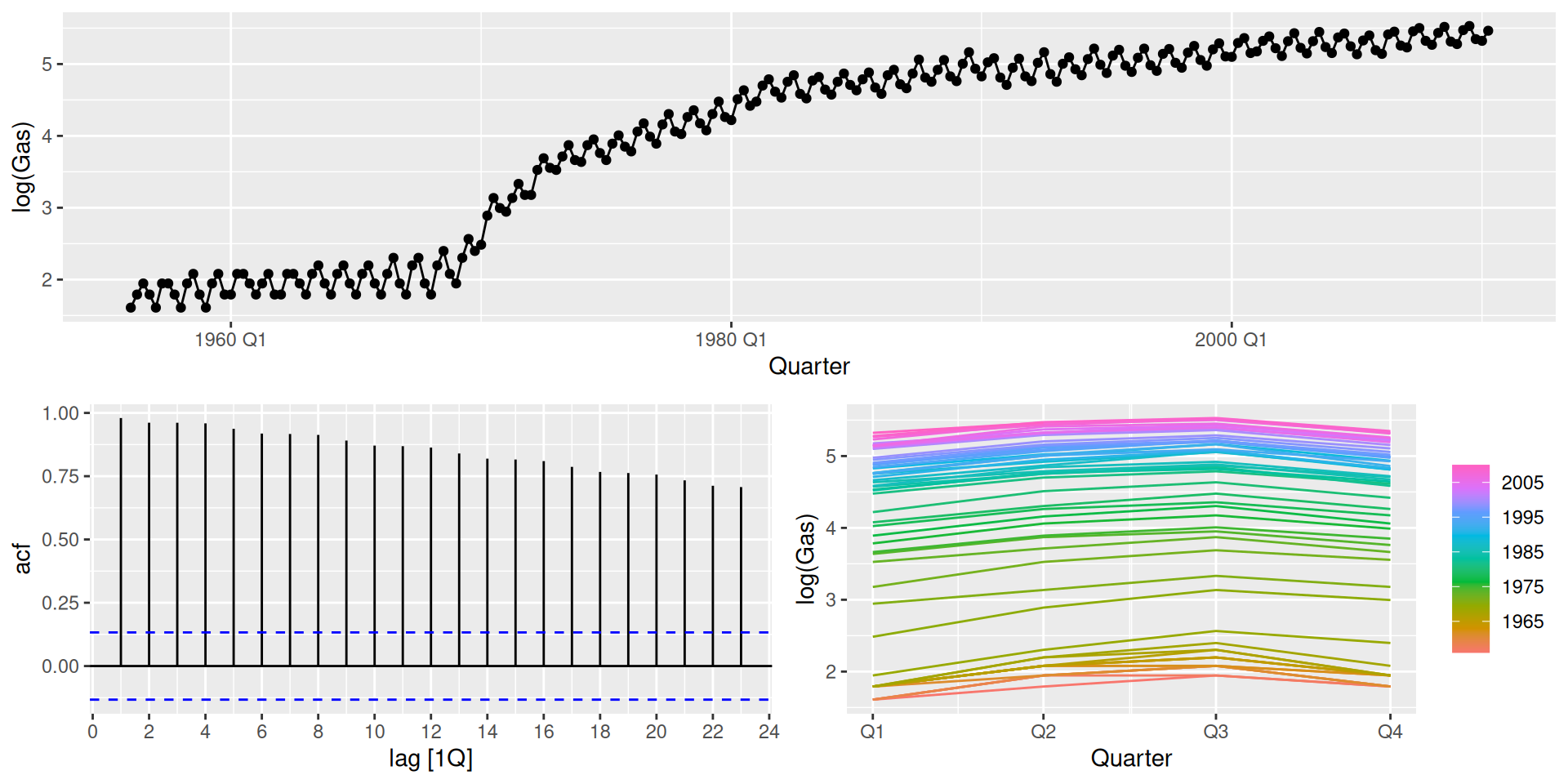

- We focus on
Gas
Train/test split
- Split the series into training and test sets.
- The test set length should match the forecast horizon.
For this example, we use the last 8 quarters as test data.
Benchmark models
Before fitting complex models, we establish benchmarks.
Common benchmark methods in tidyverts:
- Mean method:
MEAN()
- Naïve method:
NAIVE()
- Seasonal naïve method:
SNAIVE()
- Drift method:
RW(... drift())
bench_fit <- gas_train |>
model(
mean = MEAN(Gas),
naive = NAIVE(Gas),
snaive = SNAIVE(Gas),
drift = RW(Gas ~ drift())
)
Forecast
Generate forecasts with a horizon equal to the test set length.
bench_fcst <- bench_fit |>
forecast(h = nrow(gas_test))
(Optional) Plot forecasts:
bench_fcst |>
autoplot(gas_train, level = 95) |>
autolayer(gas_test, Gas, alpha = 0.7)
Forecast accuracy
We measure forecast accuracy using forecast errors:
e_{T+h} = y_{T+h} - \hat{y}_{T+h|T}
Compute accuracy metrics:
bench_acc <- bench_fcst |>
accuracy(gas_test) |>
arrange(MASE)
bench_acc
Selection rule:
- Prefer models that perform well on MASE (scale-independent).
- For seasonal data,
snaive is often a strong benchmark.
Error metrics
Using forecast errors, we can compute summary metrics:
Common error metrics
| Scale-dependent |
|
- Root Mean Squared Error
- Mean Absolute Error
|
- \sqrt{\text{mean}(e_{t}^{2})}
- \text{mean}(|e_{t}|)
|
| Scale-independent |
|
- Mean Absolute Percentage Error
- Mean Absolute Scaled Error
- Root Mean Squared Scaled Error
|
- \text{mean}(|p_{t}|)
- \text{mean}(|q_{t}|)
- \sqrt{\text{mean}(q_{t}^{2})}
|
Refit and forecast
Once a benchmark is selected based on the test set, refit it using all available data, then forecast the desired future horizon.
Example: refit snaive and forecast the next 8 quarters.
final_fit <- aus_production |>
model(
final_model = SNAIVE(Gas)
)
final_fcst <- final_fit |>
forecast(h = "8 quarters")
Communicate
Forecasting is not finished when numbers are produced.
Results must be communicated clearly and honestly.
Minimum communication checklist:
- Plot: history + forecast + prediction intervals
- Horizon: what the forecast period represents
- Baseline: state the benchmark model used
- Uncertainty: prediction intervals are essential
- Limitations: structural breaks, short samples, changing conditions
